Tungabhadra Reservoir Gate Replacement Project Faces Significant Delays
The critical infrastructure project to replace aging crest gates at the Tungabhadra reservoir in Munirabad, Koppal taluk, has encountered substantial delays, raising serious concerns about its completion within the original May-end timeline. With work progressing at a notably slow pace, officials and agricultural stakeholders are growing increasingly anxious about potential spillover beyond the scheduled deadline.
Current Status Reveals Alarming Progress Gap

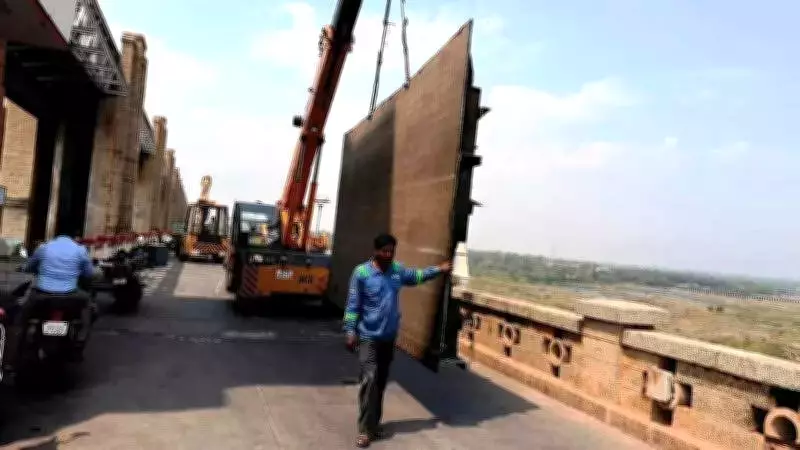

Of the total 33 crest gates slated for replacement, only 17 have been successfully installed to date. This leaves a substantial 16 gates remaining, with experts calculating that each installation typically requires approximately seven days under current conditions. This timeline suggests that completing the remaining gates could extend the project by around 112 days if current work rates persist.
Furthermore, while 25 old gates have been dismantled, eight still await removal. The fabrication process has produced 26 new gates, but installation has lagged significantly behind manufacturing. A senior engineer from the Tungabhadra Board, speaking anonymously, revealed that dismantling the remaining eight gates alone could consume at least 32 days, even at an optimistic rate of one gate every four days.
Urgent Need for Accelerated Implementation
The anonymous engineer emphasized that substantial acceleration is essential to meet deadlines. "Only if three to four teams work simultaneously can the remaining gates be installed by April-end, allowing trial runs in the first week of May," he stated. He stressed the necessity of increasing manpower and deploying multiple specialized teams to reduce installation time to three or four days per gate.
Progress on installing chain links has also been minimal, with only two of the newly fitted gates equipped so far. Additional work includes fabricating seven more gates and removing the remaining eight old ones, all while no additional workforce has been deployed—a factor that has particularly heightened concerns among the agricultural community.
Official Reassurance Amid Growing Concerns
Board secretary ORK Reddy attempted to alleviate fears, asserting that there is no immediate cause for alarm even if monsoon inflows arrive earlier than expected. "Existing chain links are in good condition. New ones are being manufactured in Chennai and will be delivered by April-end. Installation takes just a day per gate and can be done even during rains," he explained.
However, with typical reservoir inflows beginning in early June, experts caution that any delays in installation followed by mandatory operational testing could push timelines further if technical issues emerge during the process.
Agricultural Stakeholders Express Apprehension
CA Galappa, president of the Vijayanagara Farmers' Association, highlighted the persistent uncertainties surrounding timely project completion. He noted that farmers are closely monitoring the situation, given the reservoir's vital importance to regional agriculture.
The Tungabhadra reservoir serves as a crucial lifeline for Karnataka, Andhra Pradesh, and Telangana, irrigating approximately 14 lakh acres across eight districts. Beyond agriculture, it supports drinking water supplies and industrial needs, making the timely and successful completion of this gate replacement project absolutely essential for regional stability and economic continuity.
