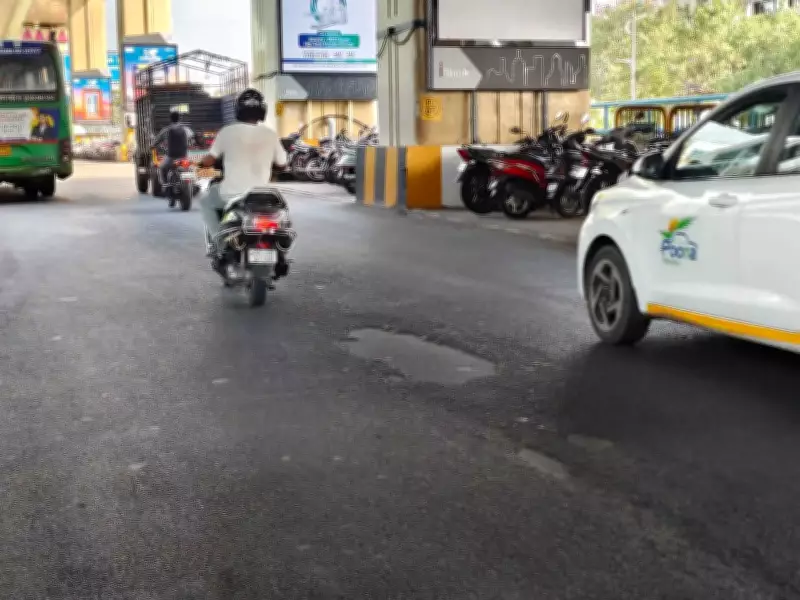

PCMC Road Repairs Delayed Again, Monsoon Pothole Woes Loom
PCMC Road Repairs Delayed, Monsoon Pothole Woes Loom

The Pimpri Chinchwad Municipal Corporation (PCMC) is facing a familiar crisis as the monsoon season approaches, with most planned road repair works unlikely to be completed before the rains hit. Civic officials attribute the delays to a combination of factors, including the model code of conduct for the ongoing MLC elections, a surge in road excavations for Maharashtra Natural Gas Limited (MNGL) pipeline projects, and fluctuations in bitumen prices linked to the conflict in West Asia.

GIS Survey Identifies Urgent Repairs

A GIS-based survey conducted earlier this year identified 56 road stretches requiring immediate repairs before the monsoon. However, work orders have been issued for only six of these projects so far. Data from the civic administration reveals that B and E wards have the highest number of repair proposals, with ten each. Yet, only two projects in B ward have received work orders, while all ten proposals in E ward remain pending.

Scope of Required Repairs

The survey recommended repairs on approximately 305 kilometers of roads at an estimated cost of Rs 243 crore. The proposed works include 14 types of interventions, such as pothole filling, sealing cracks in concrete roads, chamber repairs, road restoration, and other maintenance measures across the city. “Works worth only around Rs 30 crore to Rs 40 crore could be approved before the poll code came into force,” a senior PCMC official stated.

Wide Pickt banner — collaborative shopping lists app for Telegram, phone mockup with grocery list

Reasons for Delay

Officials explained that the repair schedule was already delayed because the civic administration took time to finalize tenders following the formation of the newly elected general body earlier this year. As a result, road maintenance works, which typically begin in February, could not be initiated on schedule.

The situation was further exacerbated by large-scale road excavation for piped natural gas (PNG) projects. Under central government guidelines, permissions for such works are deemed approved within 24 hours, allowing agencies to begin digging immediately. However, restoration of the affected road stretches remains the responsibility of the civic body. “As road excavation increased significantly, the burden of restoration work also went up. At the same time, pre-monsoon road repairs were pending, affecting the overall schedule,” the official added.

Impact on Commuters

While potholes that emerge during the monsoon will be addressed as complaints are received, officials stated that comprehensive road repairs cannot be undertaken during heavy rains. These works are now likely to be carried out only after the monsoon. This delay will leave commuters across the industrial township navigating damaged and uneven roads throughout the rainy season.

Residents Express Frustration

Residents have criticized the civic body’s failure to complete repairs on time, saying the delays would cause unnecessary hardship. Dattatray Deshmukh, a resident of Wakad, blamed the civic administration for poor planning and said the delays could have been avoided with timely action. “The municipal corporation cannot keep citing one reason after another. Proper planning should have been done well in advance. The city already struggles with inadequate drainage and road infrastructure, leading to waterlogging at several locations during the monsoon. If pothole-ridden roads are submerged under water, they could pose a serious risk to commuters and lead to accidents,” he said.

Sanjay Shinde, a resident of Chinchwad, added, “The roads were riddled with potholes last monsoon as well. These reasons sound more like excuses than genuine explanations for the delays.”
